Rising costs, lengthy timelines among challenges as city works on multiple bridge projects

One major challenge facing these projects is the significant rise in costs in recent years. Between 2021 and 2024, bridge costs have gone up by 35%. Costs for materials like concrete have risen by as much as 75%.

Getting your Trinity Audio player ready...

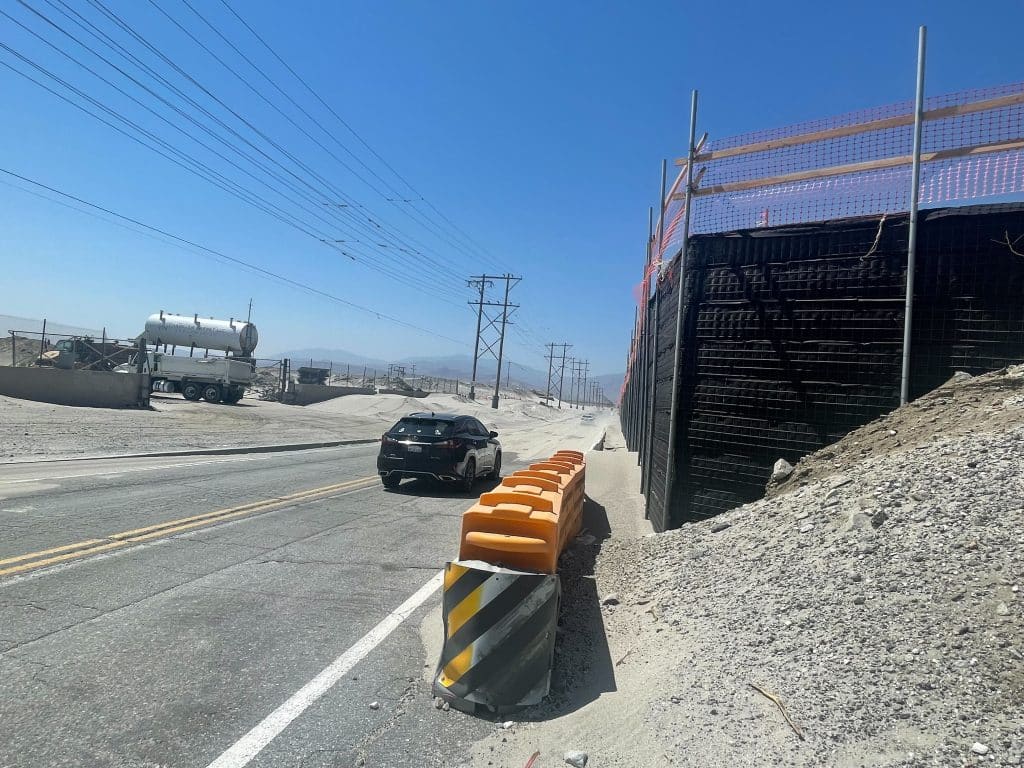

Work to widen the bridge that goes over the rail tracks near the wash on North Indian Canyon Drive is currently underway. It is one of two bridge projects planned for the area .

The City of Palm Springs is making progress on five federally funded bridge projects, with the $45 million Indian Canyon Drive bridge over the railroad currently under construction and expected to be completed in April 2026.

City Engineer Joel Montalvo provided an update to the City Council on the ongoing projects, which are in various stages of development, on Thursday evening. In addition to the Indian Canyon Drive bridge, the city is working on the $10 million South Palm Canyon bridge over Tahquitz Creek, the $40 million Ramon Road bridge, the $15 million East Palm Canyon bridge over Palm Canyon Wash, and the $100 million Vista Chino bridge at the Whitewater.

Local reporting and journalism you can count on.

Subscribe to The Palm Springs Post

“Bridge projects take a very long time from inception to actual construction,” Montalvo explained. Each project goes through multiple phases, including preliminary engineering, environmental review, right-of-way acquisition, and construction. Each of those phases can take several years to complete.

One major challenge facing these projects is the significant rise in costs in recent years. Montalvo noted that between 2021 and 2024, bridge costs have gone up by 35%, with materials like concrete increasing by as much as 75%.

“A bridge that was a certain dollar value four or five years ago is way more expensive,” he said. The Vista Chino bridge project, for example, was initially estimated at $67 million but has since ballooned to over $100 million.

Advertisement

During construction, Montalvo emphasized that roads must remain open to traffic. To accomplish this, bridges are typically built one half at a time.

“When we build a bridge, we always build one half of the bridge, and then we put traffic on top of that bridge and we move it to the other,” he explained. However, he acknowledged this can be disruptive to the public.

In addition to the five city projects, Montalvo noted that CVAG is spearheading a separate $50 million grant-funded project on Indian Canyon to address persistent issues with flooding and blow sand. That project is in the preliminary stages, with concept designs being evaluated.

“We’re working together to try to see, make sure that those bridges are coordinated with the bridge that I’m building,” Montalvo said of the CVAG project. “I’m obviously involved in all the bridges and make sure that the city’s presence is known here in these projects where CVAG is working on them.”

Montalvo concluded his presentation by asking for the council’s continued support and the public’s understanding as these complex, lengthy projects move forward.

Advertisement

“Patience and understanding from the public during construction and during the design phase,” he said when asked by City Councilmember Lisa Middleton what support his department needed. “Some folks do think we don’t move fast enough, but really, we are working at the fastest pace that a public agency can work at.”
